Risk Assessment & Threat Mapping
The “Identify” Synergy: An effective Risk Assessment (RA) is not a standalone document; it is the synthesis of your Asset Inventory, Interdependency Matrix, and Exclusion Logic. This guide explains how to map functional threats to your vessel’s specific OT topology per IACS UR E26 §6.
1. The RA Methodology (E26 vs. Best Practice)
For UR E26 compliance, the risk assessment must be “Functional-Based.” For non-mandatory vessels, we recommend a “Vulnerability-Based” approach to prioritize budget and maintenance.
Focuses on Category II & III systems. Requires formal documentation of the “Safety Impact” if a system’s Integrity or Availability is lost.
Focuses on Cost & Operational Downtime. Prioritizes “Low-Hanging Fruit” like USB lockdowns and network segmentation.
2. Functional Threat Mapping (UR E27 Alignment)
Under UR E27, you must prove that technical controls are in place to mitigate specific threats. Use this matrix to bridge the gap between your inventory and your security controls.
3. Defining Risk: Scoring & Visual Matrix

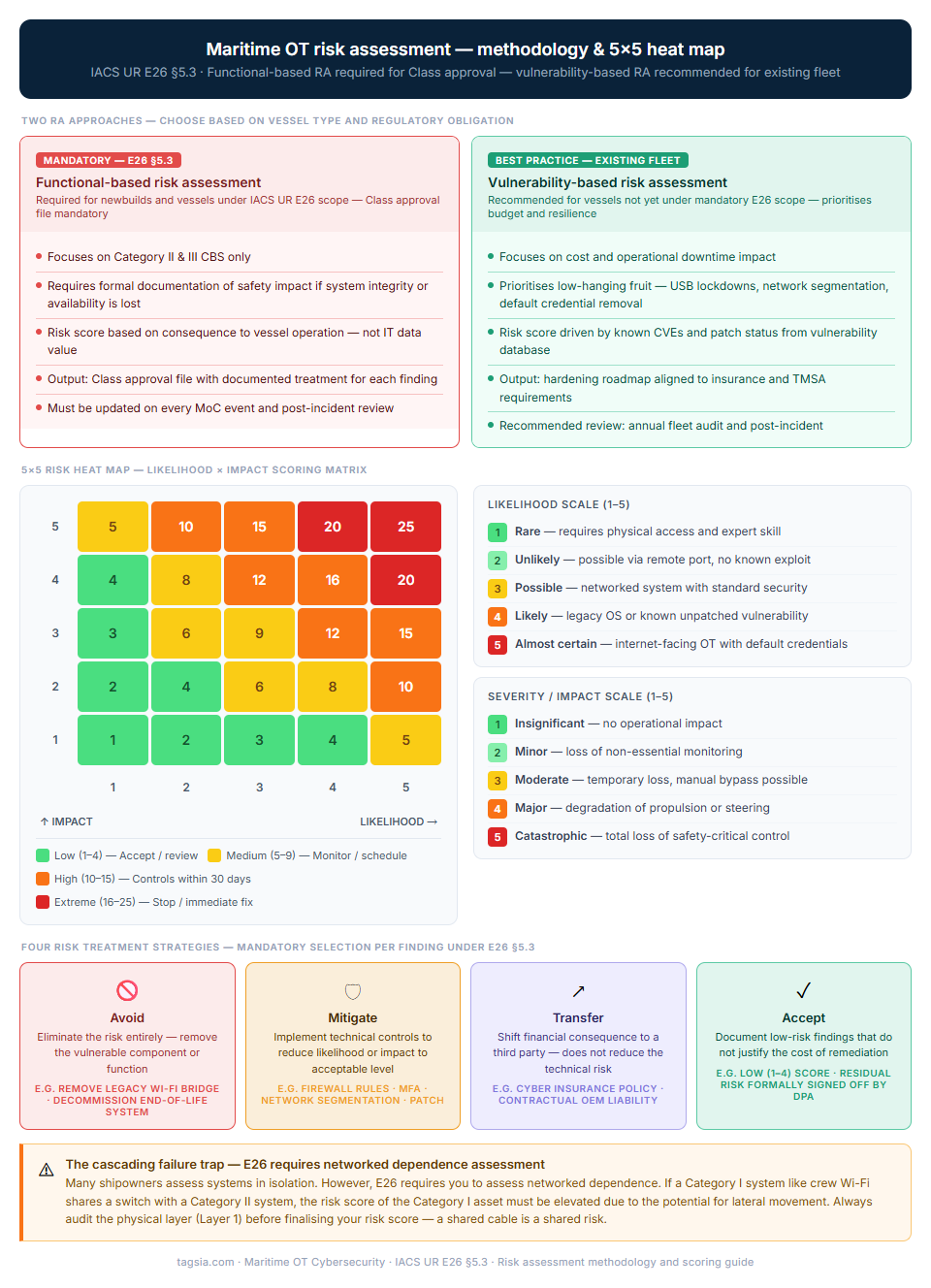

To ensure consistency across the fleet, use the following criteria and the 5×5 Heat Map to determine your risk priority.
| IMPACT | |||||
| 5 | 10 | 15 | 20 | 25 | |
| 4 | 8 | 12 | 16 | 20 | |
| 3 | 6 | 9 | 12 | 15 | |
| 2 | 4 | 6 | 8 | 10 | |
| 1 | 2 | 3 | 4 | 5 | |
| LIKELIHOOD | |||||
- 1. Rare: Requires physical access + expert skill.
- 2. Unlikely: Possible via remote port; no known exploit.
- 3. Possible: Networked system; standard security.
- 4. Likely: Legacy OS or known unpatched vulnerability.
- 5. Almost Certain: Internet-facing OT with default credentials.
- 1. Insignificant: No operational impact.
- 2. Minor: Loss of non-essential monitoring.
- 3. Moderate: Temporary loss; manual bypass possible.
- 4. Major: Degradation of propulsion/steering.
- 5. Catastrophic: Total loss of safety-critical control.
4. Risk Response & Treatment
Once a risk is scored, the Technical Manager must select a treatment strategy. This is a mandatory step for UR E26 §5.3 documentation.
5. Strategic Integration: The RA Hub
To avoid duplicating effort, your Risk Assessment must directly reference the data points already established in your other playbook sections:
6. RA Lifecycle: When to Re-Assess
A Risk Assessment is not a one-time project. Under E26 Management of Change (MoC), the RA must be updated during:
Strategic Intelligence: The “Cascading Failure”
The Auditor’s Trap: Many shipowners assess systems in isolation. However, UR E26 requires you to assess “Networked Dependence.” If a Category I (Non-Essential) system like Crew Wi-Fi shares a switch with a Category II system, the risk score of the Category I asset must be elevated due to the potential for lateral movement.
Pro-Tip: Always audit the Physical Layer (Layer 1) before finalising your risk score. A shared cable is a shared risk.
